Skip to content

How Gantt Scheduling Works

Given the work, relationships, calendars, constraints, progress, and resources, when can each task realistically happen?

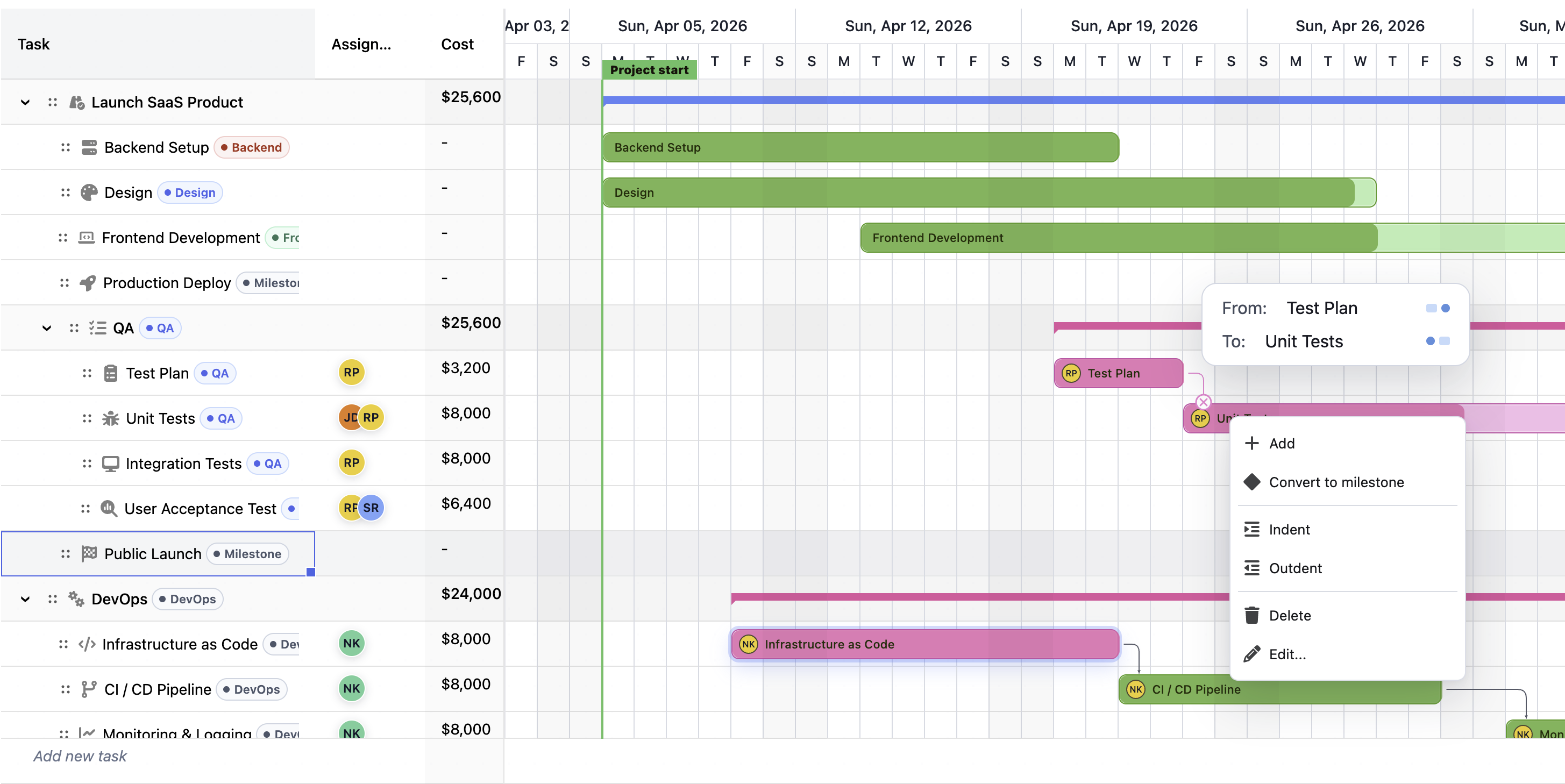

JavaScript Gantt Scheduling preview

A project plan is rarely just a list of dates. A real plan has sequencing rules, non-working days, holidays, people with limited capacity, deadlines, manual promises, and changing progress. Scheduling is the logic that keeps those pieces consistent.

Why Scheduling Matters

Without scheduling, a Gantt chart is only a drawing. It can show dates, but it cannot tell whether those dates still make sense.

Plans change constantly:

  • a design task takes longer than expected;
  • a supplier cannot start until legal approval finishes;
  • a public holiday removes a working day from the plan;
  • the same engineer is assigned to two full-time tasks;
  • a customer deadline cannot move;
  • a manager manually promises a date that conflicts with dependencies.

When any of these things happen, the project needs a visual update. It needs date calculation, conflict detection, and explanation.

Scheduling helps to understand:

  • What is the earliest realistic finish date?
  • Which tasks are blocking the plan?
  • Which delays matter and which can be absorbed?
  • Are we counting weekends and holidays correctly?
  • Are people over-allocated?
  • Which commitments are warnings instead of hard rules?
  • What changed after a dependency, progress update, or calendar change?

The value is not only cleaner task bars. The value is better decision-making.

Authored Plan vs Calculated Schedule

Every schedule starts with an authored plan. These are the dates, durations, dependencies, and assignments entered by a user or loaded from business data.

The scheduler then produces a calculated schedule. This is the version that has been checked against planning rules.

ConceptBusiness meaning
Authored planWhat the user or system originally entered.
Calculated scheduleThe dates after dependencies, calendars, constraints, progress, and resources are considered.
Automatic taskA task the engine may move to keep the plan valid.
Manual taskA task that keeps the user's date, even if the engine reports a conflict.
Schedule warningA signal that the displayed commitment does not match the planning logic.

This distinction is important. A planner may enter "Build starts April 1", but if "Design" finishes on April 3 and Build depends on Design, the calculated schedule should not pretend Build can start on April 1.

For business users, this is the difference between a wish list and an operational plan.

The Core Scheduling Logic

Scheduling is a sequence of business rules applied in a predictable order.

First, the engine validates the plan. It checks whether referenced tasks exist, whether dates are usable, whether calendars are valid, and whether dependencies create impossible loops. This prevents the chart from showing a misleading result.

Next, it normalizes the work. Durations, milestones, progress, actual dates, split work, manual tasks, and summary tasks are interpreted into a consistent model.

Then it applies relationships. If Task B cannot start until Task A finishes, Task B is moved to the first valid date. If two tasks can overlap, lead or lag is included. If the project is scheduled backward from a deadline, the same logic is applied in reverse so work is placed as late as possible while still meeting the finish target.

After that, the engine applies calendars, constraints, actual progress, and optional resource leveling. Finally, it rolls child dates up into parent tasks and calculates critical path and slack.

The important business point is this: scheduling does not simply add duration to a start date. It calculates dates through a network of rules.

Calendars: Realistic Dates

Calendars define what counts as working time. They are one of the most important parts of scheduling because duration only has meaning when the system knows when work is allowed to happen.

A task with a duration of five days does not always finish five calendar days later. If the team works Monday through Friday and the task starts on Thursday, five working days usually finishes the following Wednesday, not Monday. If there is a holiday in the middle, it may finish Thursday instead.

That is why calendars exist:

  • to exclude weekends and holidays from working duration;
  • to model different work weeks by team, region, or resource;
  • to make lag and lead time match business expectations;
  • to prevent tasks from being scheduled into closed time;
  • to keep timeline calculations aligned with how the organization actually works.

Calendars are especially important for distributed teams. A product team in Europe, an implementation team in the United States, and a support team in India may not share the same holidays or working hours. If every task uses the same naive calendar, the plan may look aligned while being operationally wrong.

Project, Task, and Resource Calendars

Not every calendar answers the same question.

Calendar typeBusiness question it answers
Project calendarWhat are the default working days for this project?
Task calendarWhen is this specific kind of work allowed to happen?
Resource calendarWhen is this person, machine, team, or role available?

A project calendar might say the company works Monday through Friday. A task calendar might say a deployment can happen only during a weekend maintenance window. A resource calendar might say a contractor is available only three days per week.

These calendars affect different planning decisions:

  • Task calendars shape the date math for the task itself.
  • Resource calendars shape capacity, availability, and over-allocation checks.
  • The project calendar provides the default when no more specific calendar is used.

This lets the same Gantt chart represent real business constraints instead of a single generic work week.

Working Time vs Calendar Time

Scheduling often needs to distinguish between working time and calendar time.

Working time counts only open working periods. Calendar time counts elapsed days regardless of whether anyone is working.

Both are useful, but they answer different business questions:

Time modelUse it when
Working timeThe delay depends on when people can work, such as development, QA, review, or implementation.
Calendar timeThe delay happens regardless of working hours, such as shipping transit, legal waiting periods, curing time, or customer notice periods.

For example, a three-day engineering task should usually skip the weekend. A three-day shipping wait may continue through the weekend. A two-day approval lag may be working days if it depends on staff availability, or calendar days if it is a contractual cooling-off period.

This difference is small in configuration, but large in business impact. Choosing the wrong model can move delivery dates by days or weeks.

Dependencies: The Logic Between Tasks

Dependencies describe why one piece of work affects another.

The most common dependency is finish-to-start: one task must finish before the next can begin. But real plans need more than that:

RelationshipBusiness example
Finish-to-startDevelopment must finish before QA starts.
Start-to-startDocumentation can start when implementation starts.
Finish-to-finishFinal review must finish when packaging finishes.
Start-to-finishA replacement support process must start before the old process can end.

Dependencies can include lag or lead.

Lag adds waiting time. For example, QA may start two working days after a build is delivered so the environment can be prepared.

Lead allows controlled overlap. For example, documentation may start one day before development finishes because enough information is already available.

This is how a project becomes a network instead of a checklist. The scheduler uses that network to identify the earliest or latest valid dates for each task.

Constraints, Deadlines, and Commitments

Not every date in a project means the same thing.

Some dates are flexible planning inputs. Some are hard business commitments. Some are warning targets. Scheduling needs to treat them differently.

Date typeBusiness meaning
Dependency-driven dateThe date comes from predecessor and successor logic.
ConstraintA rule that limits when a task may start or finish.
DeadlineA target date that should warn when missed.
Actual dateA historical fact that should not be recalculated away.
Manual dateA user-entered commitment that should stay visible.

A hard constraint might represent a booked launch slot, a regulatory filing date, or a customer workshop that cannot move. A deadline might represent a desired completion target. The distinction matters because a deadline should raise a warning, while a hard constraint can force the schedule to show a conflict.

Good scheduling does not hide these conflicts. It makes them visible so the team can decide whether to change scope, add capacity, renegotiate the date, or accept risk.

Progress and Actuals

Once work starts, scheduling must respect reality.

If a task actually started on Monday, the engine should not move its start to Wednesday just because a predecessor changed later. If a task is partially complete, the remaining work may need to be rescheduled while the completed portion stays fixed.

This matters for business reporting. Teams need to distinguish between:

  • what was planned;
  • what has already happened;
  • what remains;
  • what the current forecast says.

Progress-aware scheduling helps keep forecast dates useful after execution begins. Without it, every recalculation can accidentally rewrite history.

Resource Capacity and Leveling

A dependency-valid plan can still be impossible if it assigns too much work to the same resource.

For example, one designer may be scheduled at 100 percent on a design review and 100 percent on a prototype at the same time. The dependencies may be valid, but the staffing plan is not.

Resource checks answer capacity questions:

  • Is a person, role, machine, or team over-allocated?
  • Which tasks compete for the same capacity?
  • Can a task move without delaying the project?
  • Should the scheduler warn only, or delay eligible work automatically?

Resource leveling is the process of delaying some work to reduce over-allocation. It is useful when the goal is to produce a more realistic delivery forecast without manually dragging every task.

Auto-leveling should be understood as a planning aid, not a substitute for management judgment. It can show a feasible sequence, but the team still decides whether to add people, split work, reduce scope, or accept a later finish.

Critical Path and Slack

The critical path is the chain of tasks that controls the project finish date.

Tasks on the critical path have no room to slip without affecting the final delivery date. Tasks with slack can move by some amount before they delay the project.

This is one of the most valuable outputs of scheduling because it tells leaders where attention matters most.

SignalBusiness use
Critical taskProtect it closely because delay affects delivery.
SlackUnderstand how much flexibility exists.
Late start or late finishKnow the last safe date before the plan slips.
Critical dependencySee which relationship is driving the schedule.

Critical path is not only for project managers. Product, operations, implementation, and leadership teams use it to focus discussion. A one-day slip on a non-critical task may not matter. A one-day slip on the critical path may change the launch date.

Forward and Backward Planning

Scheduling can work from a start date or from a finish date.

Forward scheduling starts at the project start and asks: "How soon can we finish if we begin now?"

Backward scheduling starts from the required finish date and asks: "When is the latest each task can start and still meet the deadline?"

Planning styleBest for
Forward schedulingDelivery forecasts, implementation plans, product development, internal roadmaps.
Backward schedulingFixed launch dates, events, regulatory deadlines, contract commitments.

Many businesses use both. A team may first schedule backward from a contractual go-live date to understand the latest safe start dates, then schedule forward from today's progress to see whether the plan is still realistic.

Common Use Cases

Scheduling is useful anywhere a timeline depends on business rules rather than simple date entry.

Product Delivery

Product teams can model design, development, QA, release preparation, documentation, and launch dependencies. Calendars keep team holidays and non-working days out of the forecast, while critical path shows which tasks threaten the release.

Implementation and Professional Services

Services teams can coordinate customer onboarding, discovery, configuration, data migration, training, and go-live activities. Scheduling makes it clear when a customer delay affects the whole project and when it can be absorbed.

Construction and Field Operations

Field plans often depend on crews, equipment, inspections, weather windows, and subcontractor availability. Calendars and resource capacity help avoid plans that look possible on paper but fail in execution.

Manufacturing and Supply Chain

Manufacturing schedules need to account for machine availability, setup time, batch dependencies, supplier lead times, and shipping delays. Working-time and calendar-time logic are both important here.

Marketing and Events

Campaigns and events have fixed dates, approval chains, vendor deadlines, and production windows. Backward scheduling helps teams understand the latest safe dates for creative, review, print, shipping, and launch steps.

Support and Operations Change

Operational changes often need cutover windows, staffing coverage, training, rollback plans, and blackout periods. Task and resource calendars help represent when work is actually allowed.

What Makes a Schedule Trustworthy

A schedule is trustworthy when users can understand why dates moved.

RevoGrid Gantt provides that by separating inputs from calculated results and by surfacing schedule origins, warnings, conflicts, resource issues, and critical path signals.

For business users, the most important questions are:

  • Did this task move because of a dependency?
  • Did a calendar remove working time?
  • Did a constraint force this date?
  • Did actual progress pin part of the schedule?
  • Did resource leveling delay the task?
  • Is the task critical, or does it have slack?

When those answers are visible, the Gantt chart becomes an explanation of the plan instead of only a picture of the plan.

How This Relates to Microsoft Project

RevoGrid Gantt follows familiar Microsoft Project-style scheduling concepts where they make sense for a web grid:

Planning conceptRevoGrid Gantt behavior
Manual and automatic tasksManual dates can stay visible while automatic tasks move with the plan.
Forward and backward schedulingProjects can schedule from a start date or from a required finish date.
Dependency typesFinish-to-start, start-to-start, finish-to-finish, and start-to-finish relationships are supported.
Lag and leadWaiting time and overlap can be included in dependency logic.
Constraints and deadlinesHard scheduling rules and warning targets are treated differently.
CalendarsProject, task, and resource calendars can shape dates and capacity.
Critical pathSlack and critical tasks are calculated from the resulting schedule.
Resource over-allocationCapacity issues can be warned about or reduced through leveling.

The goal is not to clone every desktop behavior. The goal is to bring the scheduling concepts teams expect into typed, deterministic, web-friendly project data.

Practical Planning Guidance

For most teams, the healthiest scheduling approach is:

  • use automatic tasks for work that should follow dependencies;
  • keep manual tasks for real commitments or temporary planning overrides;
  • define calendars before trusting finish dates;
  • treat deadlines as warnings unless the date truly cannot move;
  • review resource over-allocation before trusting delivery forecasts;
  • use critical path to focus management attention;
  • preserve actual dates so execution history remains stable.

The scheduler cannot decide business priorities by itself. It provides the calculated plan, warnings, and trade-offs so the team can make better decisions.
